Building Hope

Capital Campaign Construction Project

Expanding Our Space to Serve More Women in Recovery

A Place to Grow Capital Campaign

The long anticipated journey is finally coming to fruition as the construction of the Brown and Childs Houses gains momentum! Breakthru House wishes to thank everyone who made this endeavor possible. Your commitment and support is so very appreciated as we continue our mission of transforming the lives of women and their children struggling with alcohol and drug addiction by providing a long-term residential program to empower them to experience physical, emotional, and spiritual healing through recovery.

Construction Progress Update

Week of Mar. 18, 2026

We’re excited to share another positive progress update on the Breakthru House project. The homes continue to move forward beautifully, reflecting the hard work and dedication of the construction team and everyone involved in keeping this project on track.

Project Updates:

  • All flooring has now been installed

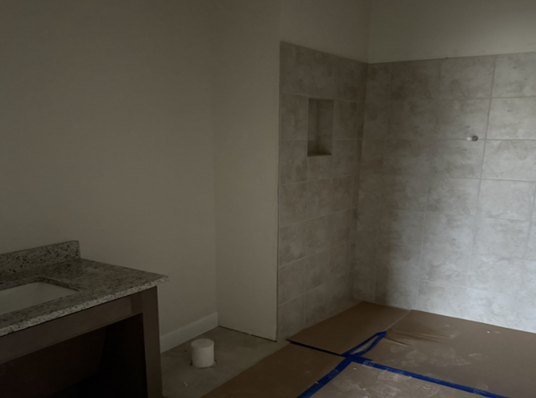

  • Tile backsplash installation began yesterday
  • Plumbing trim installation is underway starting today
  • Mirrors, shelves, and shoe mold are scheduled for installation on Friday

  • Grading has been rescheduled for this week following last week’s weather delays

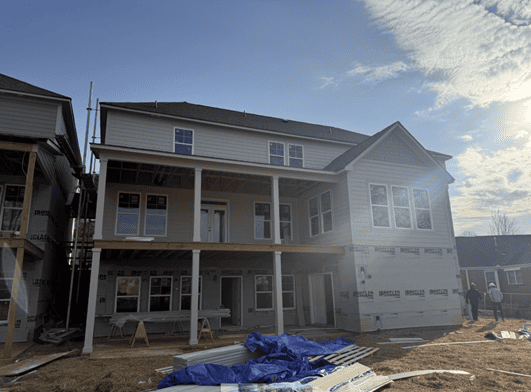

  • Brickwork is officially complete
  • Low voltage and electrical trim were completed last week

Thank you for your continued support and encouragement as we move closer to completion.

Week of Mar. 03, 2026

With spring quickly approaching, it’s wonderful to see this project entering its final stretch. The steady progress across all trades truly shows how far we’ve come and how close we are to the finish line.

Here’s the latest update for this week:

  • Tile work has wrapped up successfully.
  • Mechanical trim is slated to begin next week.
  • Back flooring installation is kicking off this week.
  • Electrical work, heating and air tasks, and additional flooring are all on the schedule for next week.
  • Our ribbon‑cutting date has been officially set for April 23rd.

Week of Feb. 23, 2026

Week of Feb. 10, 2026

We have another encouraging update on the Breakthru House project this week. Progress is moving smoothly, and each phase brings us closer to completion. Here are the latest details:

Project updates include:

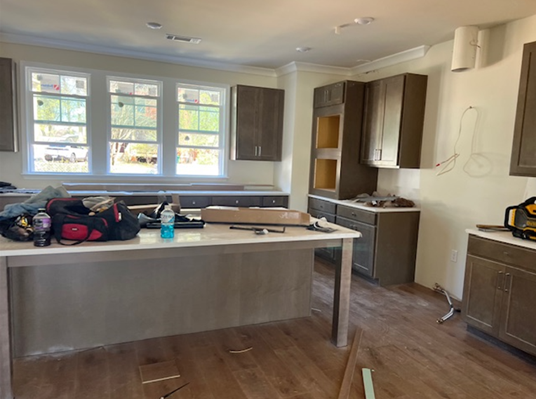

  • Building A has been sanded, and cabinets are being delivered and installed today
  • Building B is scheduled to be sanded on Thursday
  • Cabinet drop‑off for Building B is scheduled for Friday, with installation planned for Monday
  • Interior trim installation for both houses will begin next week

Thank you all for your continued support and positivity!

Week of Feb. 03, 2026

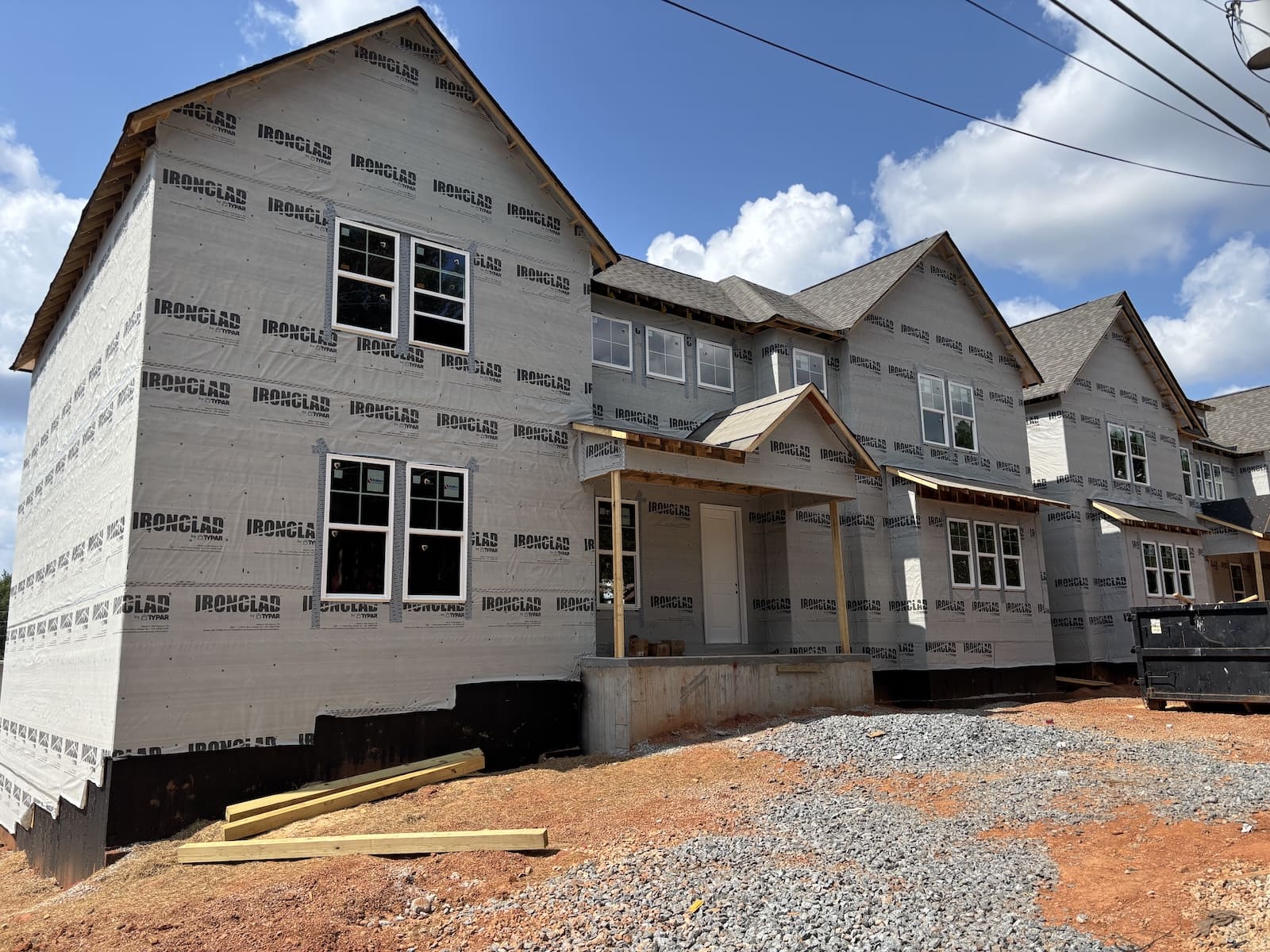

Despite the winter weather we’ve experienced, the Breakthru House project continues to move forward, with an updated completion timeline set for this spring.

Project updates include:

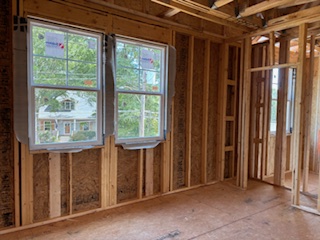

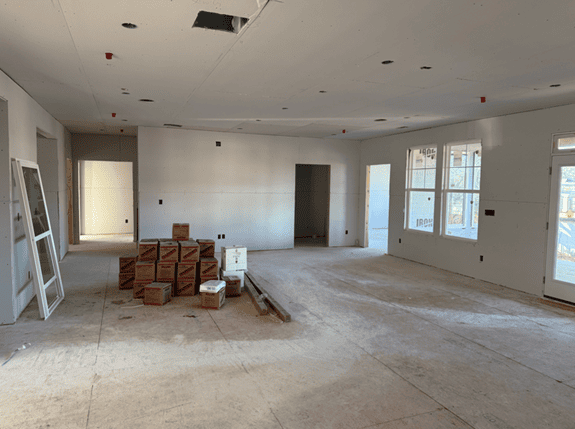

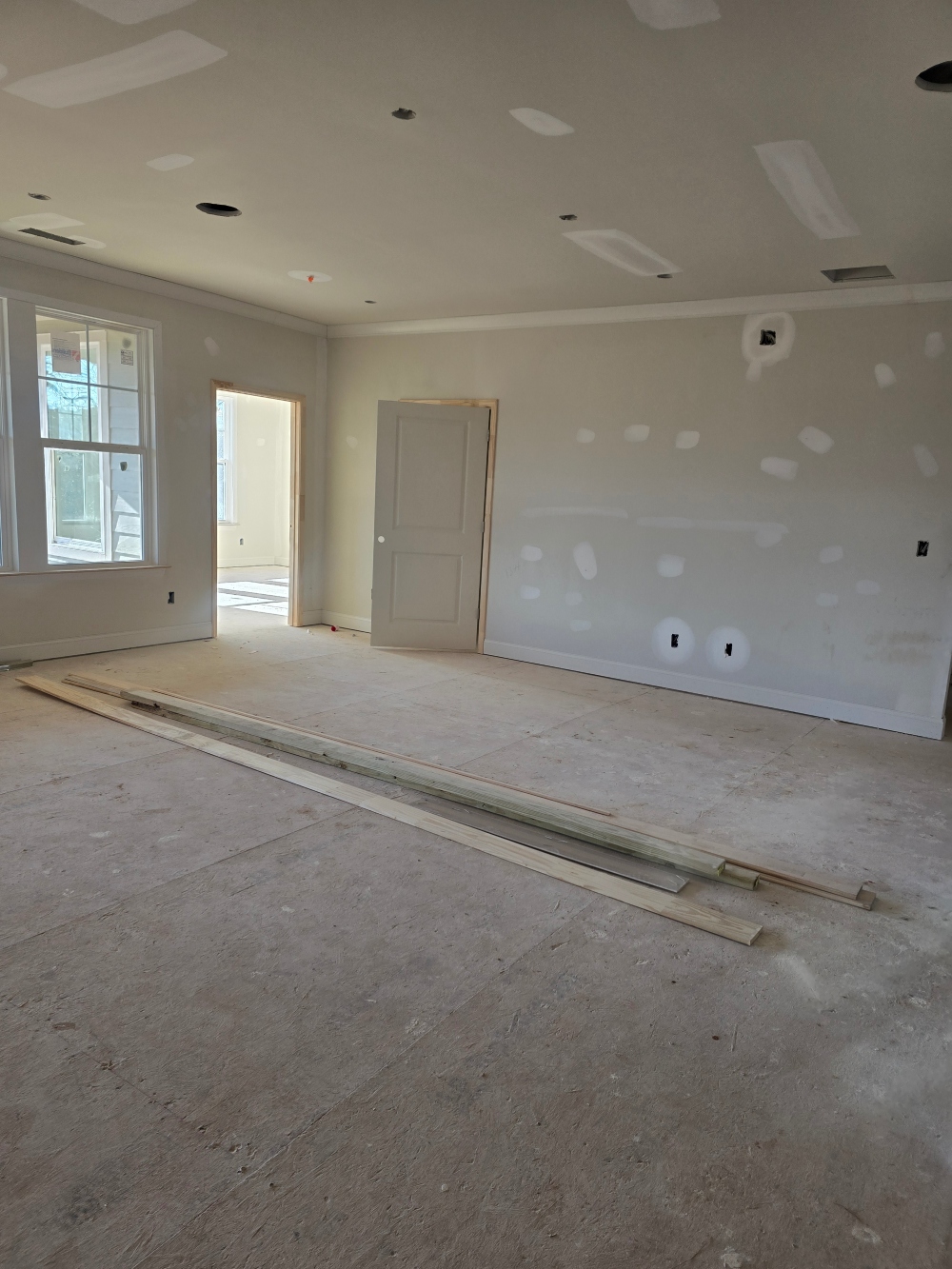

  • Drywall has been hung and remains on schedule for completion next week

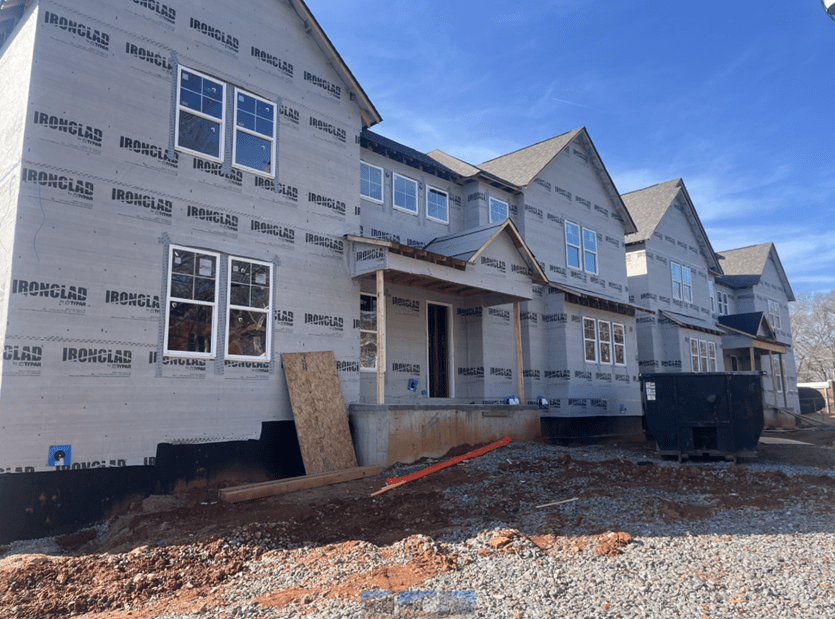

  • Siding was delivered on Friday
  • Flooring selections were finalized yesterday

Week of Jan 27, 2026

Nearly a month into the new year, the Breakthru House construction project continues to make strong progress toward completion. We are encouraged by the steady momentum as several key milestones come together.

This Week’s Updates:

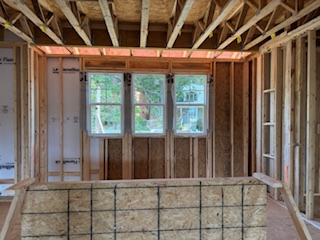

  • HVAC units are being securely bolted in place
  • Drywall installation begins Wednesday, with an estimated completion timeline of approximately 15 days

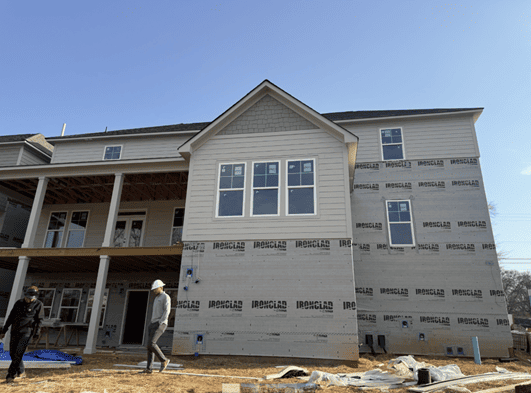

  • ColorPlus siding installation is commencing this week

Upcoming Milestones:

  • Cabinet installation is scheduled to begin in approximately two weeks
  • Brick and mortar colors have been finalized, with installation expected to begin within the same two-week timeframe

Week of Jan. 5, 2026

We are pleased to share the following construction milestones achieved this week at Breakthru House:

  • Successfully completed the pre-drywall inspection with Ronnie, Karen, BreNita, Cameron, and Jill
  • Fire foam installation finalized on Tuesday
  • Mechanical inspection completed with DeKalb County on Thursday

These milestones represent steady progress as we continue moving this important project forward.

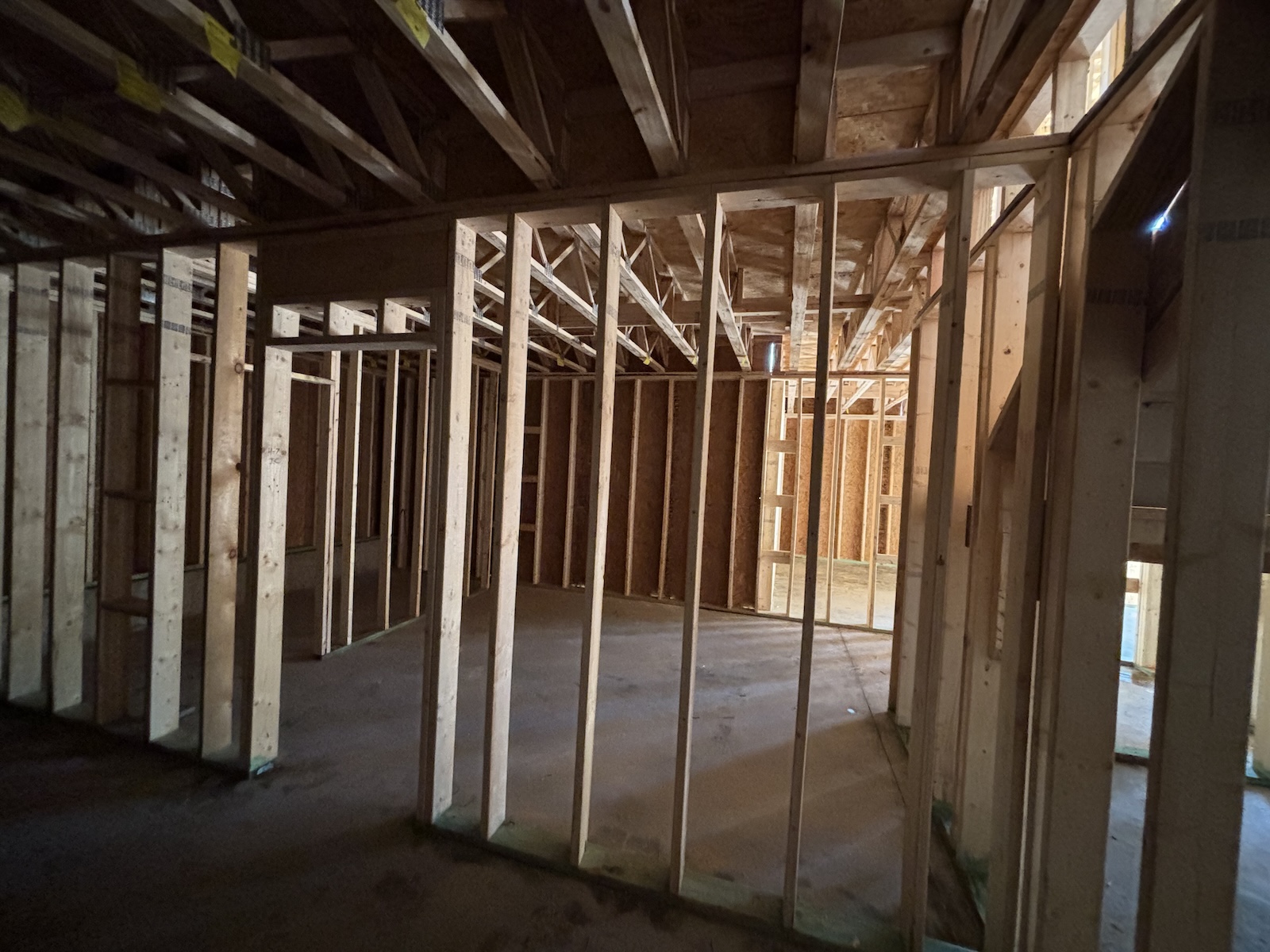

Week of Dec. 15, 2025

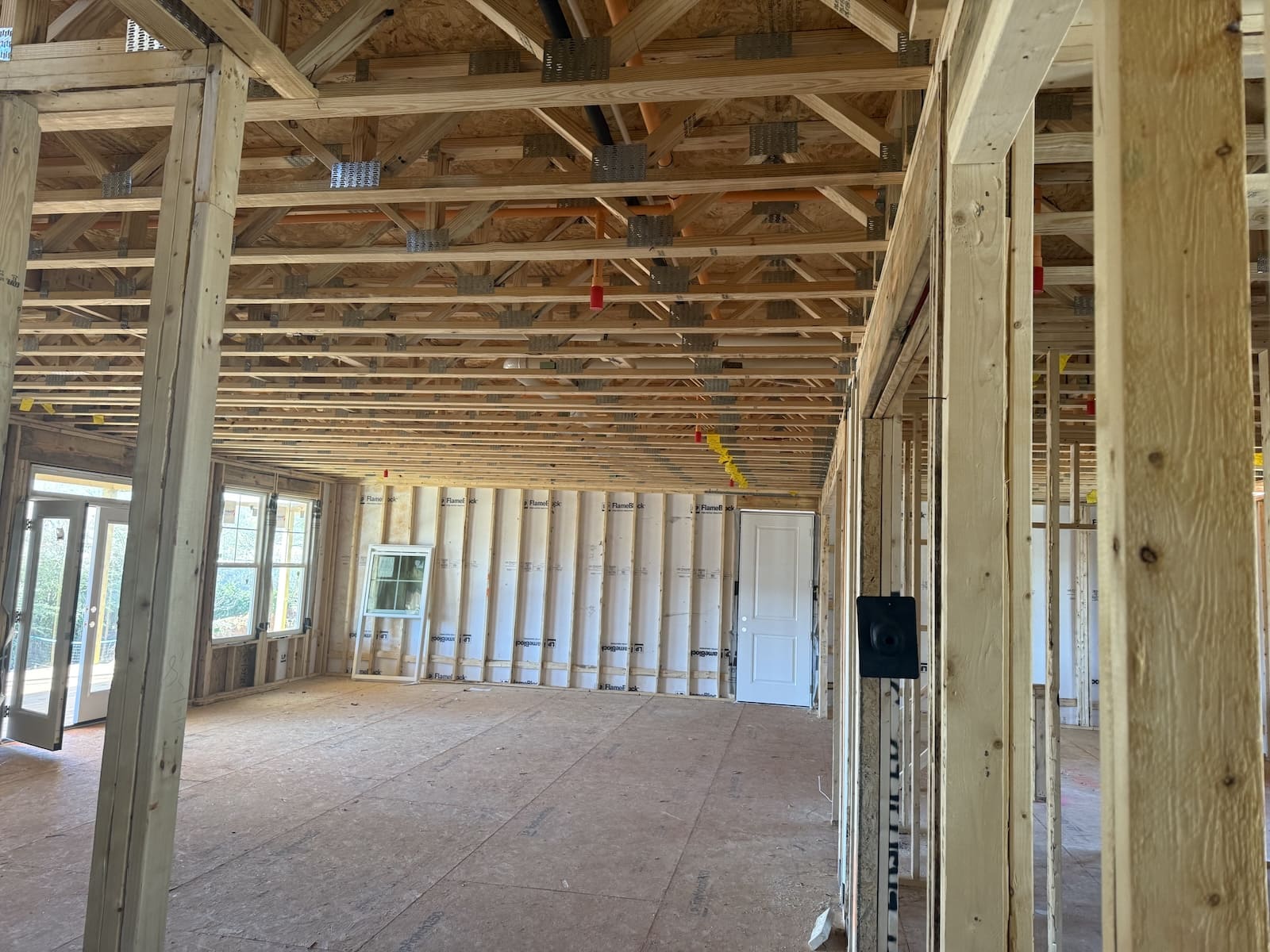

We’re happy to share another encouraging update on the progress at Breakthru House! Please see the updated photos below.

  • The sprinkler system has been successfully installed and is now completed.
  • HVAC and electrical rough ins are starting this week.
  • Low-voltage work is scheduled to begin next week.

We are excited to continue moving forward with this build as we get closer to creating a space that will truly make a lasting difference in the lives of the women we serve.

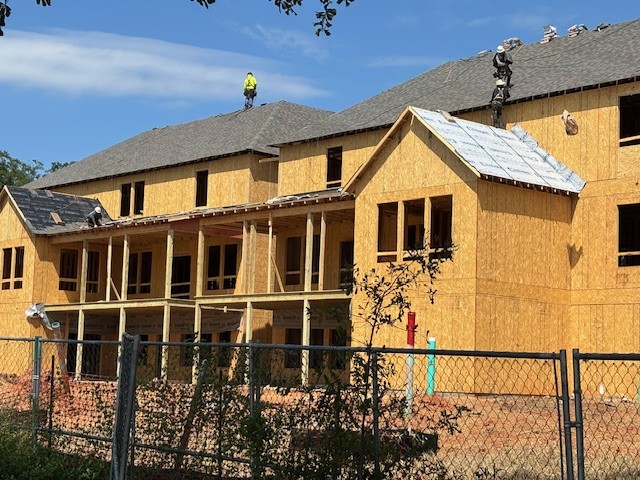

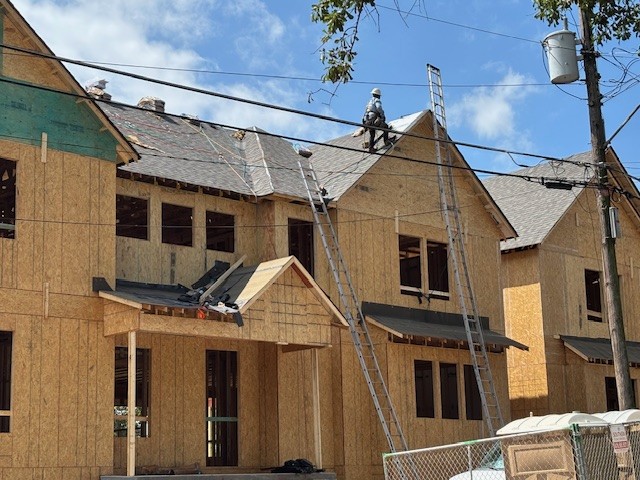

Week of Oct. 07, 2025

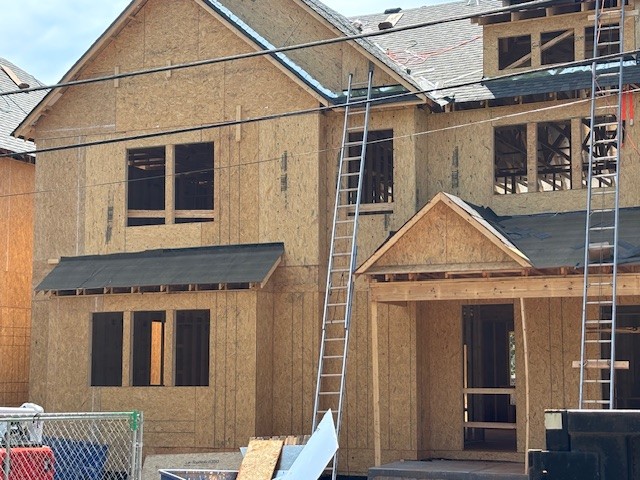

Week of Sep. 22, 2025

Week of Sep. 15, 2025

Week of Sep. 8, 2025

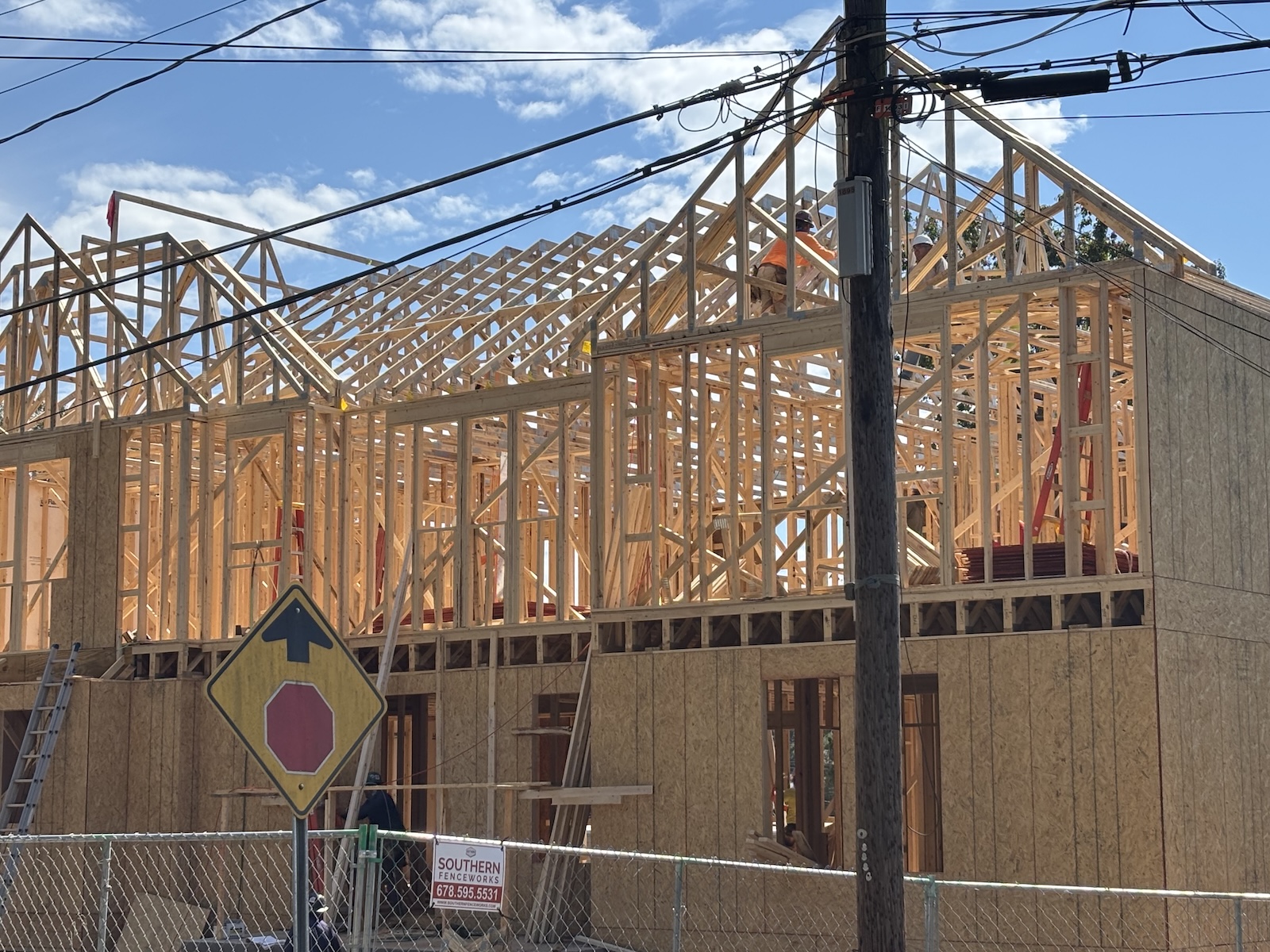

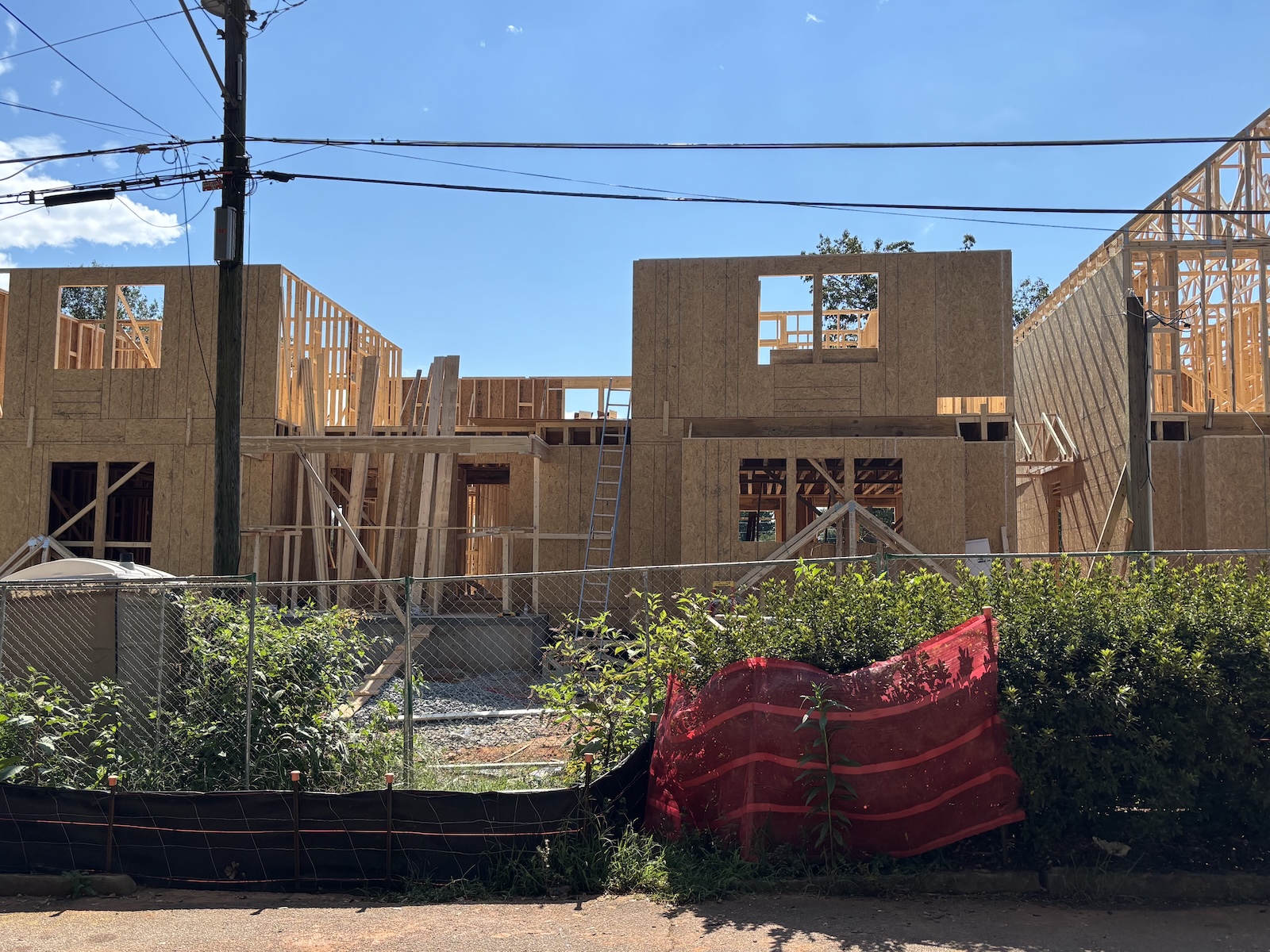

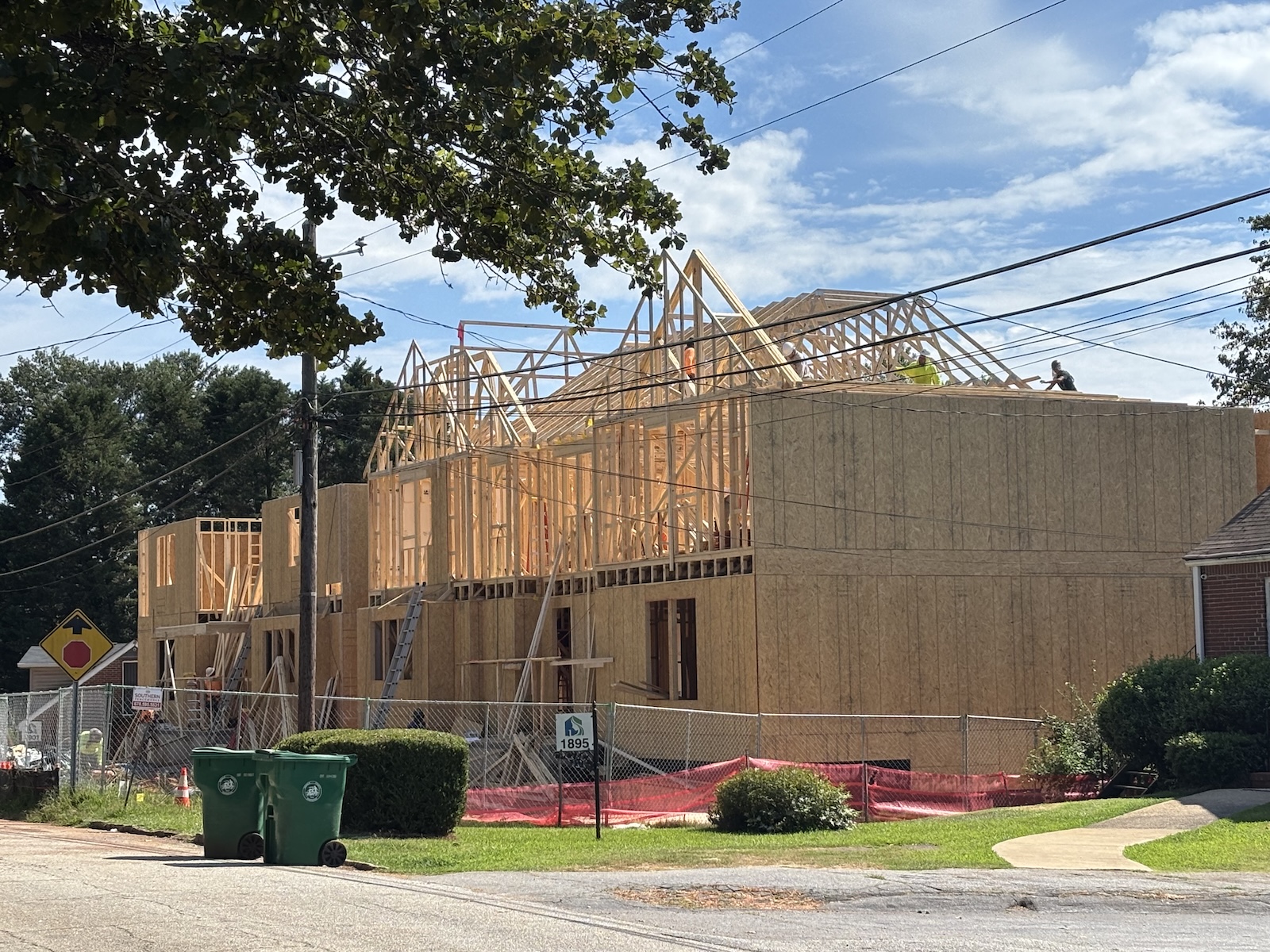

Week of Sep. 2, 2025

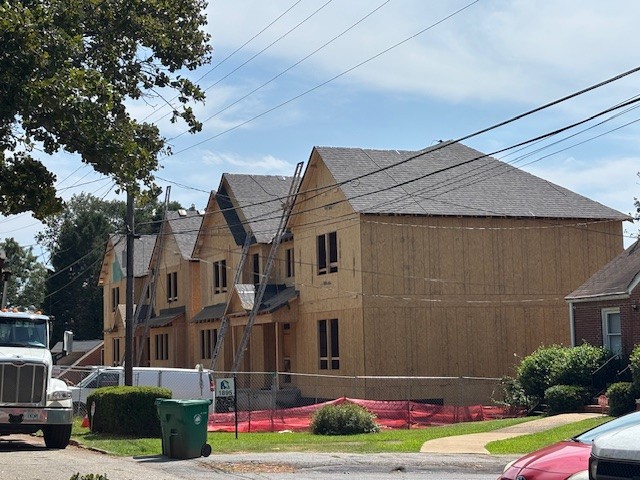

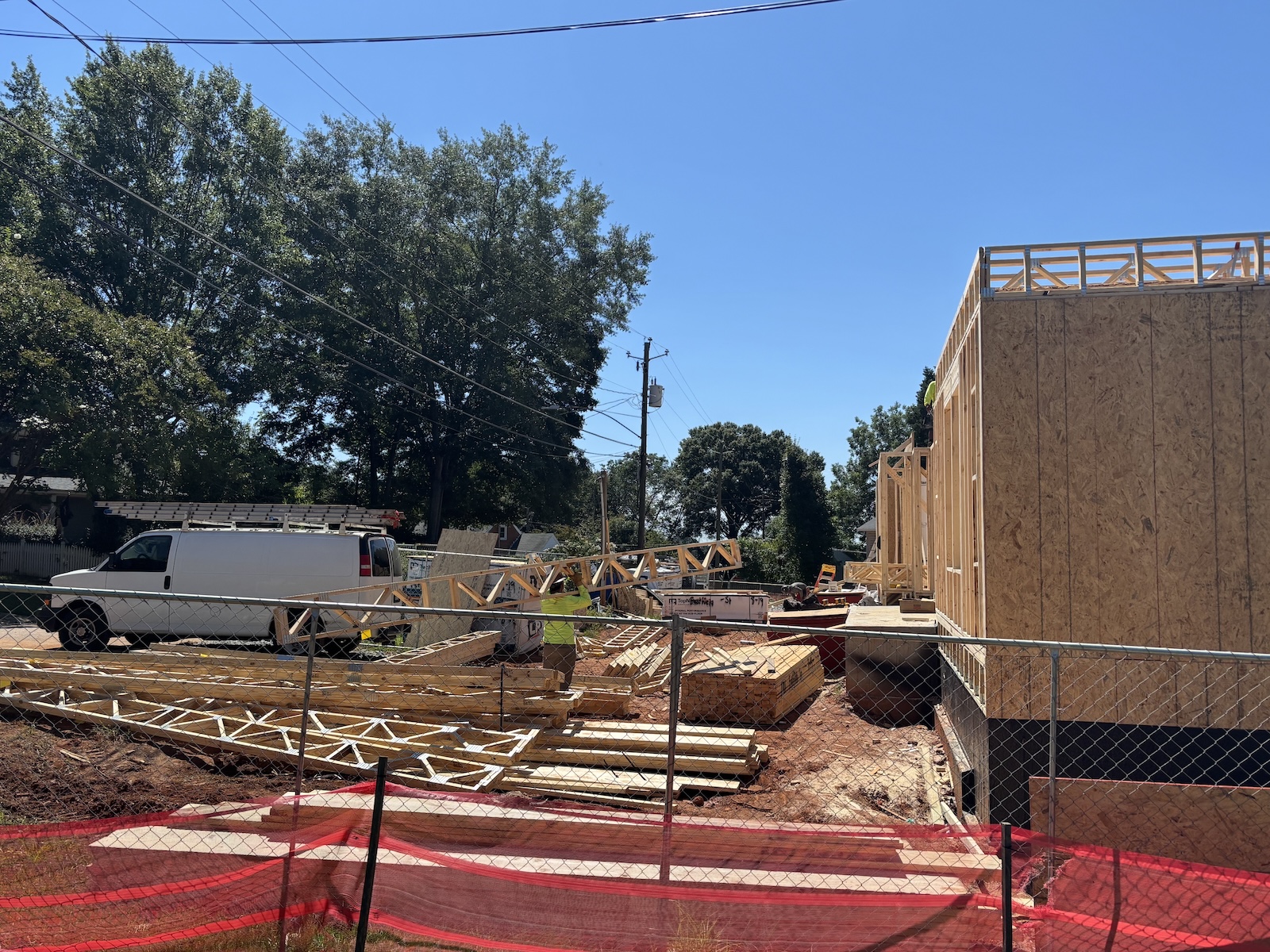

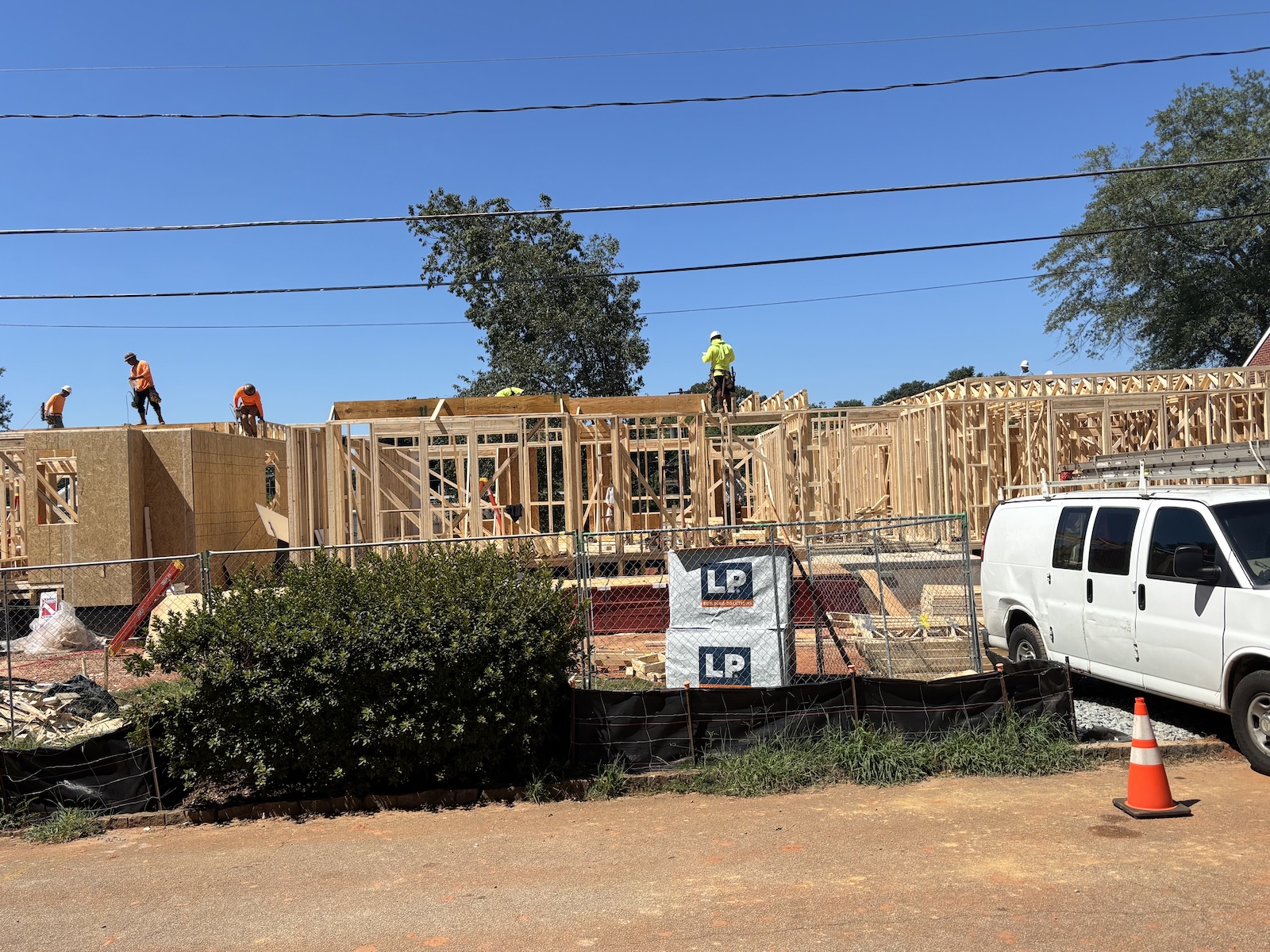

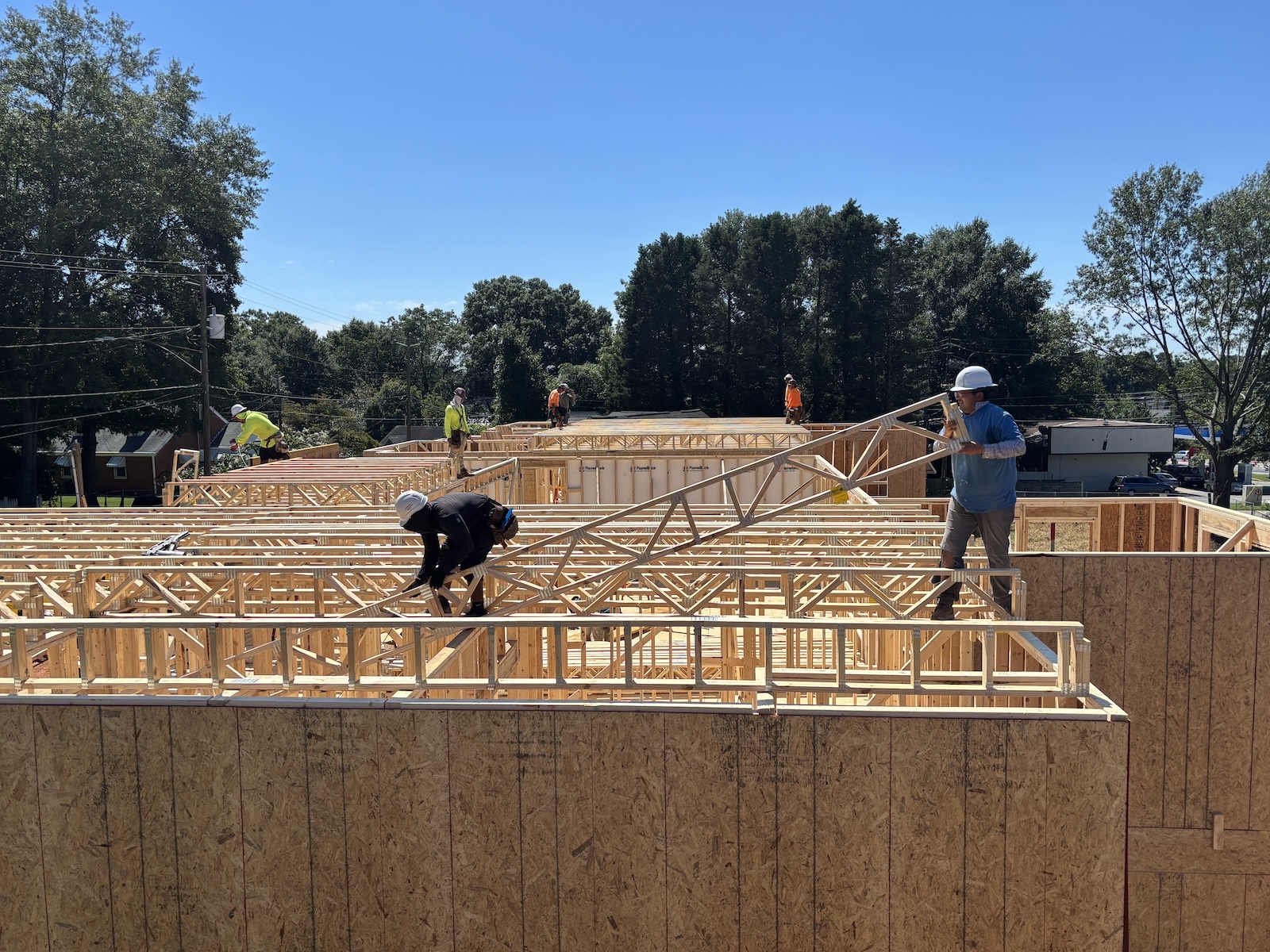

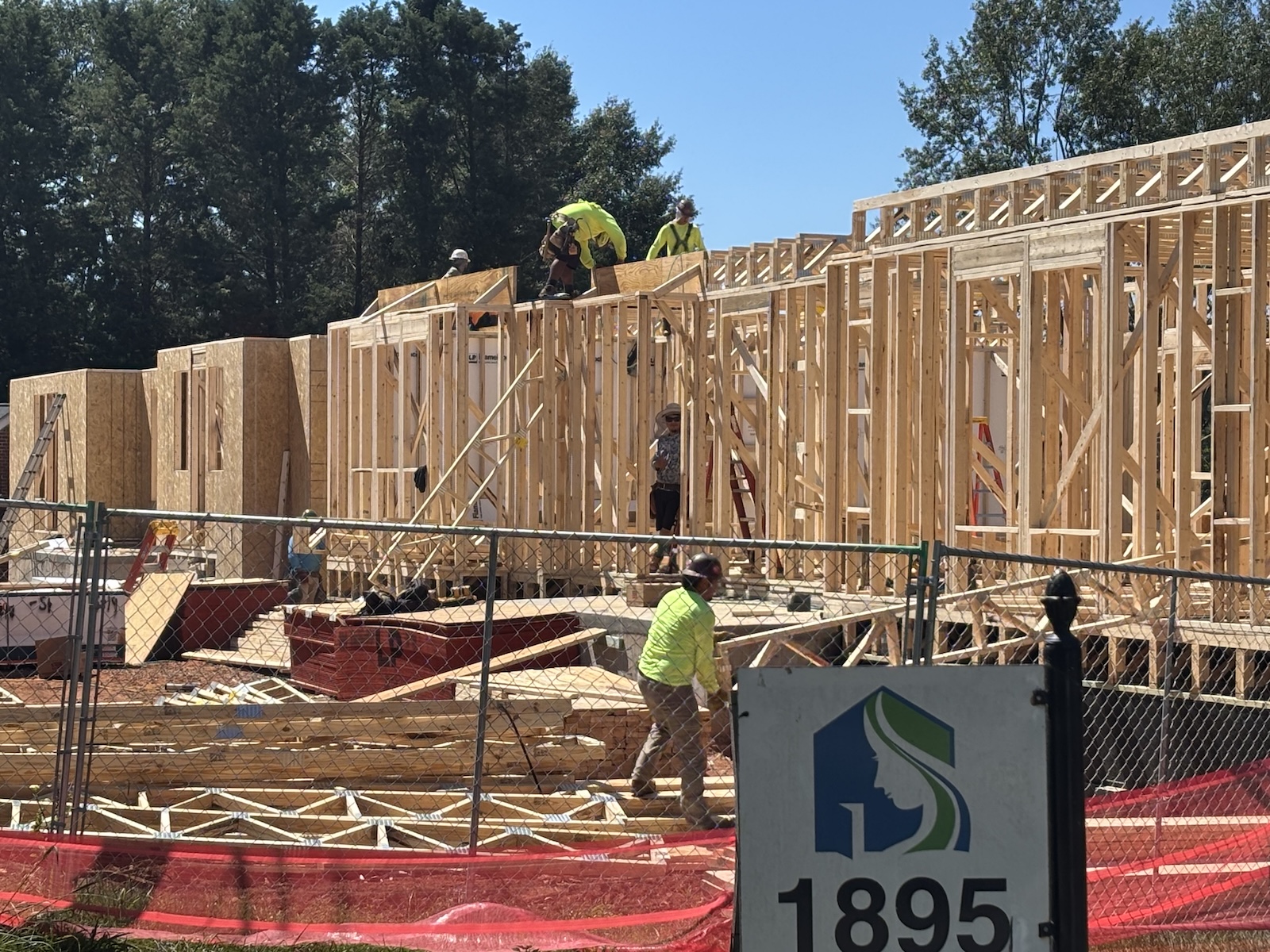

Week of Aug. 25, 2025

Together, We Can Heal and Rebuild Lives

Addiction can affect anyone, regardless of their background, age, or circumstance. Breakthru House supports women in overcoming substance abuse and reclaiming their lives. Join us in empowering women to achieve lasting recovery and brighter futures.

×
